45




            d




            &




            ri



          DEMOLITION AWARDS SUPPLEMENT 2014



            WardDemolition



          Universityof Auckland


          ScienceCentre


          Building 302,


          New Zealand


          A roomful of radioactive Cobalt-60 that


          could not be removed sitting directly


          under the demolition site was just one


          of many challengesWard Demolition


          facedwhen it was contracted by


          Fletcher Construction to demolish a 14


          storey science education building at the


          University of Auckland, New Zealand.


          Situated in the CBD on the


          intersection of a four-lane road and


          amotorway slip road, the building


          coming downwas still connected to


          an adjoining education building. There


          was also another multi-level campus


          building 5m (16.5 ft) away andmore


          than 20,000 students crossing through


          the area daily.


          The first jobwas to secure the


          vault containing the Cobalt-60 against


          damage and the potential escape of


          radioactivematerial. After calculating


          stress and vibration loads, two to three


          layers of overlapping steel plates each 20mm


          (0.8 inch) thick were laid over the 0.6m (2 ft)


          concrete casement and a deflection plate laid over


          the areawith soft padding underneath. All work near


          the vault was carried out by hand and rubble above


          crushed to reduce risk of breakthrough.


          The tower was next. The top five levels were cut


          and craned that then enabled a Komatsu PC600


          with a 35m (115 ft) reach to remove


          the remaining structure inmanageable


          pieces.


          Dust suppression protocols were


          put in place, and pedestrian and traffic


          management plans activated to further


          reduce risk. Plywood hoardings around


          the lower levels of themain building


          were lined and battened to reduce noise


          levels andwork began on separating the


          two buildings.


          The biggest challenge was that


          the ‘live’ building, still attached, was


          being used for teaching and conducting


          scientific experiments sensitive to


          vibration.


          To keep vibration to aminimum,


          the concrete wall connecting the two


          buildings and the steel tie-ins were


          removed using hand tools, leaving a


          100mm (4 inch) separation between


          the two structures. Even after separating,


          machines andmethodology had to be


          chosen carefully to reduce the impact


          of ground vibration and on several


          occasions work was halted until an


          experiment was completed.


          There were no injuries on the site, a challenging


          project was kept under control and brought in on


          time, and the client and the construction company


          were happy with the result.



            Keltbray



          2-3Piccadilly,


          London, UK

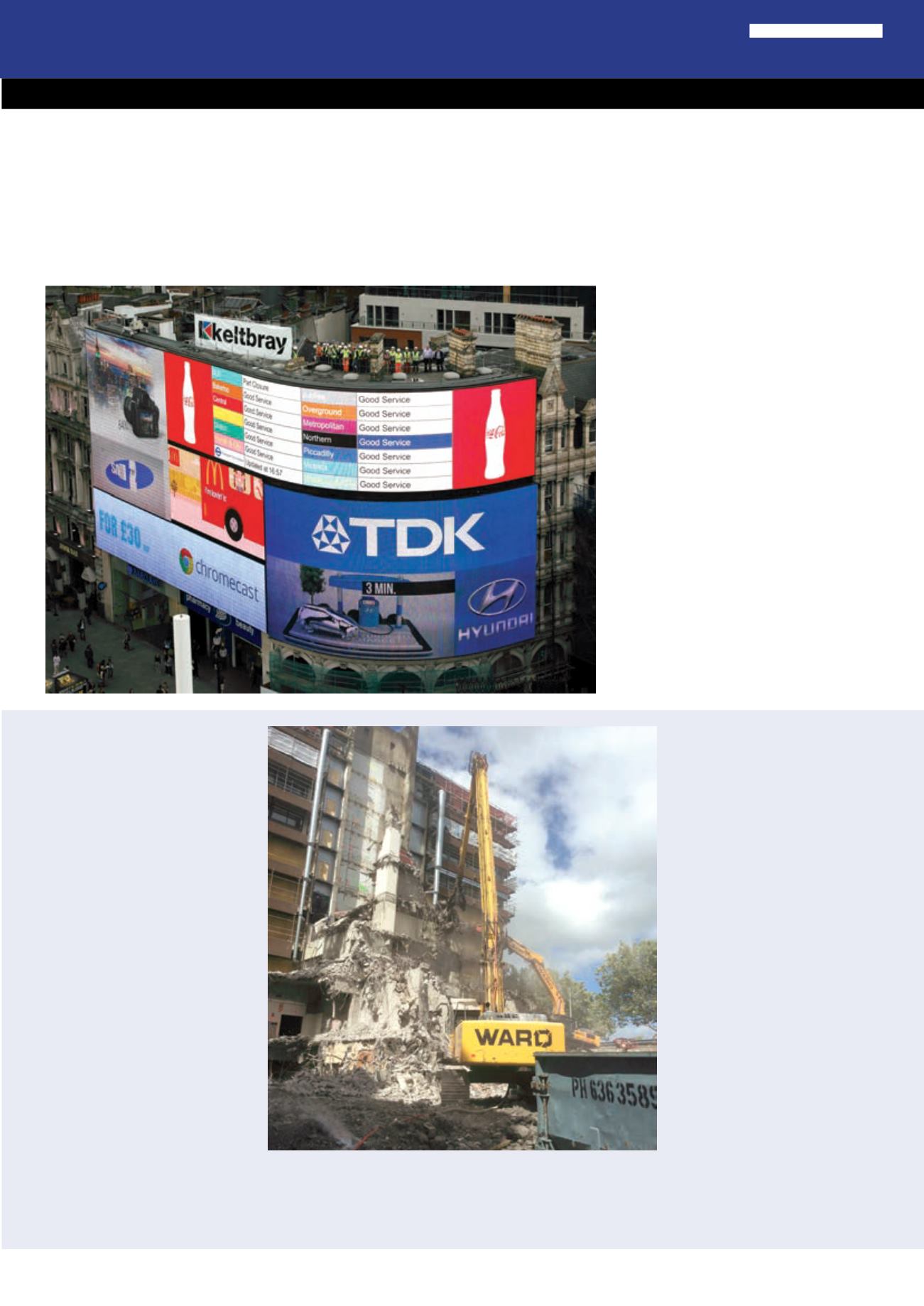

          The complexity of the 2-3 Piccadilly project was


          evident from the start. Given the condensed but yet


          highly populated surroundings, the job facedmany


          technical obstacles. Despite this, operations such


          as carrying out effective and safe deliveries was


          achieved and improved uponwhere possible.


          The site was locatedwithin the Piccadilly Circus,


          one of London’s busiest andmost recognizable


          landmarks. It is placed on the corner of Shaftesbury


          Avenue and Regent Street, both of which are


          recognisable and densely populated streets and is


          part of Westminster’s Core Central Activities Zones


          (Core CAZ) andWest End Special Retail Policy Area.


          The only existing area inwhich deliveries could


          possibly come in and out fromwas located around


          the rear of the site in Denman Street. All work on


          site also had to take into consideration that two


          live stores (Boots and Barclays) were still in full


          operation below an area of the site.


          The intentionwas to combine the two existing


          retail units to create a large single unit that is opened


          up internally with new consistent floor plates at


          basement to second floor level. The floors from third


          floor upwards remain unaltered. To achieve these


          modifications, the existing ground, mezzanine, first


          and second floor levels were demolished together


          with the internal load bearingwalls. These were


          then replacedwith a new steel frame comprising of


          columns and beams that would support the existing


          structure above the second floor together with the


          new concrete floor slabs from ground to second floor.


          The new steel columns were also supported on new


          pad foundations installed below the basement.


          A new external staircase on the second floor


          rooftop areawas also constructed to provide an


          alternative route of access.


          With the site being such an iconic London


          landmark it was crucial all relations with the public


          were done in an appropriatemanner. For example


          restrictions were in place to limit the amount of


          noise created. Set hours were determined prior to


          commencing to ensure that the effect on nearby


          neighbours would be limited. Constant liaison


          with all nearby businesses was also fundamental,


          particularly given the nature of some of the


          businesses. The project was delivered on time and


          within budget.


          WORLD


          DEMOLITION


          AWARDS2O14


          URBAN/CONFINED SPACEAWARD


          continued
